Aomori Offshore (Japan Sea, south) is a designated Promotion Zone under Japan’s Renewable Sea Area Act, the law that sets out how sea areas are allocated for offshore wind. Round 3 selected Tsugaru Offshore Energy LLC (JERA, Green Power Investment, Tohoku Electric Power) for a 615MW fixed-bottom project off Tsugaru City, with COD planned for June 2030.
This page tracks where the project stands and what gets decided next, using primary sources. It is updated monthly.
1. Where Aomori Japan Sea South Stands (October 2026)
| Status | Promotion Zone (designated 3 October 2023) |
|---|---|
| Foundation | Fixed-bottom |
| Tender round | Selected in Round 3 (December 2024) |
| Developer | Tsugaru Offshore Energy LLC (JERA, Green Power Investment, Tohoku Electric Power) |
| Size and price | 615MW (41 × Siemens Gamesa 15MW); JPY 3.0/kWh |

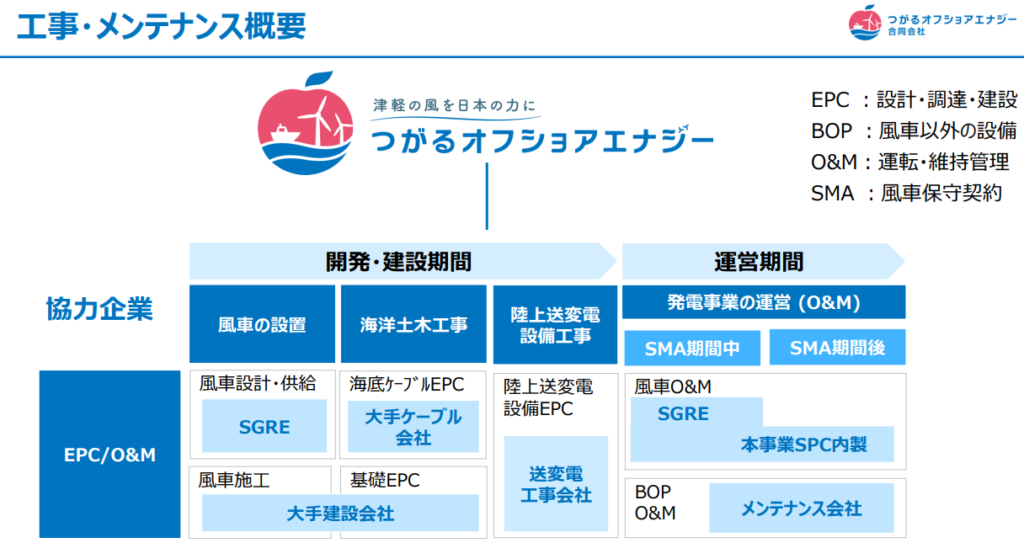

| Schedule | Plan at selection: onshore works 2026, offshore works 2028, COD June 2030 |
| Next steps | EIA final report; start of onshore works |
2. From Designation to Construction: Timeline
| Date | Event | Source |
|---|---|---|
| Oct 2023 | Designated as a Promotion Zone | METI |
| Dec 2024 | Round 3 selects Tsugaru Offshore Energy LLC at JPY 3.0/kWh | METI |
| Feb 2026 | Selected developer gives notice of its draft EIA report | MOE |
3. EIA Status: Selected Developer at Draft Report Stage
Japan’s environmental impact assessment runs in four stages: a primary document, a scoping document, a draft report with survey and prediction results, and a final report. The selected developer’s procedure has reached the draft report. Most unsuccessful bidders withdrew their procedures in 2025, but some, including one off Ajigasawa, remain.
| Project | Developer | Stage | Notice |
|---|---|---|---|
| Aomori Japan Sea South offshore wind (provisional) | Tsugaru Offshore Energy LLC | Draft report | 2026/02 |
| Aomori Japan Sea South offshore wind (provisional) | Ajigasawa Offshore Wind Power | Scoping document | 2022/02 |
| Aomori Japan Sea South offshore wind (provisional) | RWE Renewables Japan, Mitsui & Co., Osaka Gas | Primary document | 2021/10 |
| Aomori Japan Sea South offshore wind (provisional) | Japan Wind Development | Scoping document | 2018/06 |
4. Site Conditions
Almost the whole zone is under 50m deep, suited to fixed-bottom foundations. Aomori Port is the planned base port, with Aomori and Tsugaru ports for operations and maintenance.
For a cost comparison with other zones on the same assumptions, see 👉 Cost Realities of Japan’s Offshore Wind: LCOE and IRR.
What to Watch Next
- Whether onshore works start in 2026, as planned at selection.
- The EIA final report, the stage after the draft report.
- How it compares with Round 2. Round 2 projects at the same JPY 3.0/kWh have seen postponed onshore works and turbine changes.
