Offshore Happo Town and Noshiro City in Akita is a designated Promotion Zone under Japan’s Renewable Sea Area Act, the law that sets out how sea areas are allocated for offshore wind. Round 2 selected Happo Noshiro Offshore Wind GK (ENEOS Renewable Energy, Iberdrola, Tohoku Electric Power) for a 375MW fixed-bottom project. However, onshore works planned for January 2026 have been postponed, and a new schedule is under review, as the developer told the council in February 2026.
This page tracks where the project stands and what gets decided next, using primary sources. It is updated monthly.
1. Where Happo and Noshiro Stands (October 2026)
| Status | Promotion Zone (designated 13 September 2021) |
|---|---|
| Foundation | Fixed-bottom |
| Tender round | Selected in Round 2 (March 2024) |

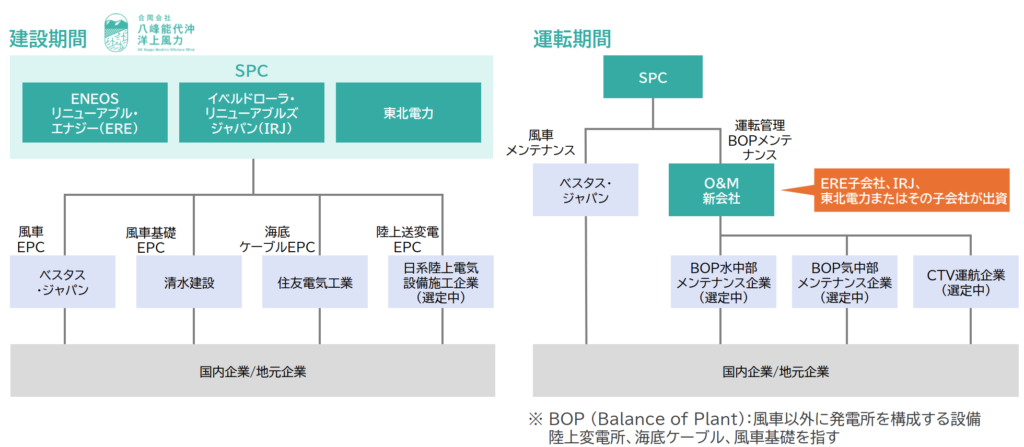

| Developer | Happo Noshiro Offshore Wind GK (ENEOS Renewable Energy, Iberdrola Renewables Japan, Tohoku Electric Power) |
| Size and price | 375MW (25 × Vestas 15MW); JPY 3.0/kWh |

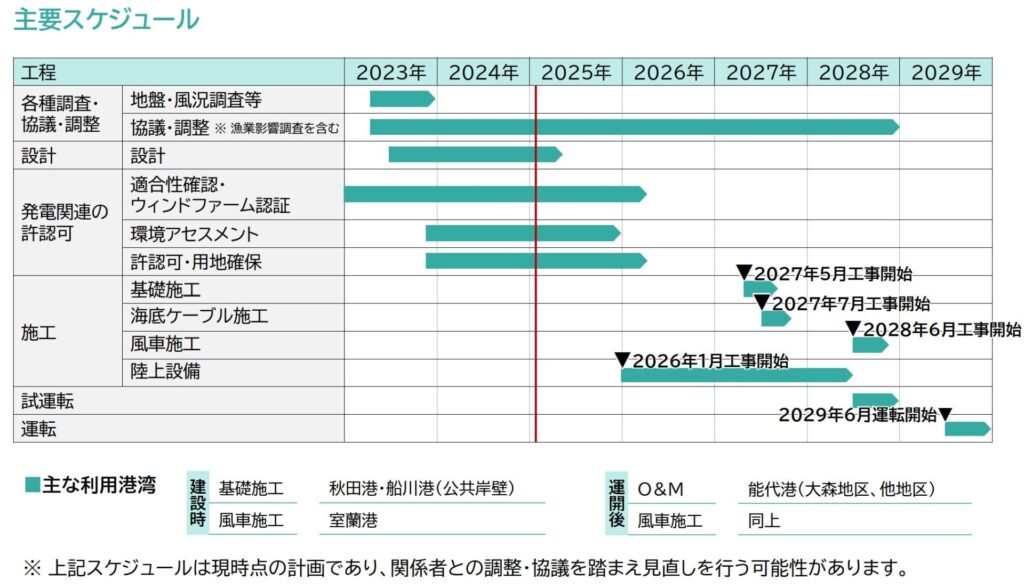

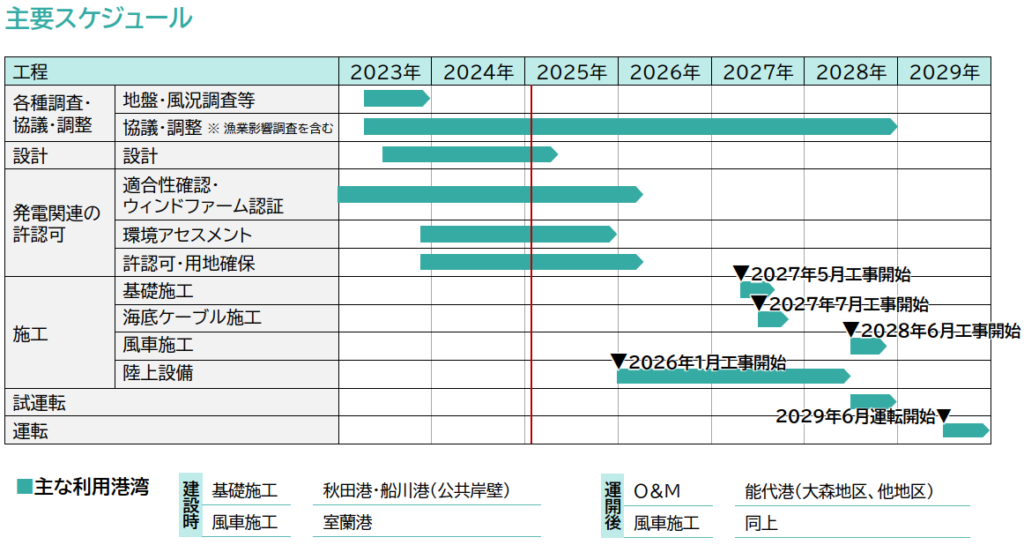

| Schedule | Onshore works (planned January 2026) postponed; new schedule under review. COD at selection: June 2029 |
| Next steps | A revised construction schedule; the EIA final report |
2. From Designation to Construction: Timeline
| Date | Event | Source |
|---|---|---|
| Sep 2021 | Designated as a Promotion Zone | METI |
| Mar 2024 | Round 2 selects Happo Noshiro Offshore Wind GK at JPY 3.0/kWh | METI |
| Aug 2024 | Selected developer gives notice of its draft EIA report | MOE |
| 25 Feb 2026 | 6th statutory council, the forum where national and local government, municipalities and fishers agree how the area is used. The developer explains that onshore works are postponed because the business environment has changed | METI |
The developer says the new schedule, including the start of works, is under review, and that it intends to complete the project in line with its plan, taking account of the government’s measures for the business environment.
3. EIA Status: Selected Developer at Draft Report Stage
Japan’s environmental impact assessment runs in four stages: a primary document, a scoping document, a draft report with survey and prediction results, and a final report. The selected developer’s procedure has reached the draft report. A scoping document from JERA and J-POWER, which were not selected, also remains on record.
| Project | Developer | Stage | Notice |
|---|---|---|---|
| Happo and Noshiro offshore wind (provisional) | Happo Noshiro Offshore Wind GK | Draft report | 2024/08 |
| Happo and Noshiro offshore wind (provisional) | JERA and J-POWER | Scoping document | 2023/04 |
4. Site Conditions

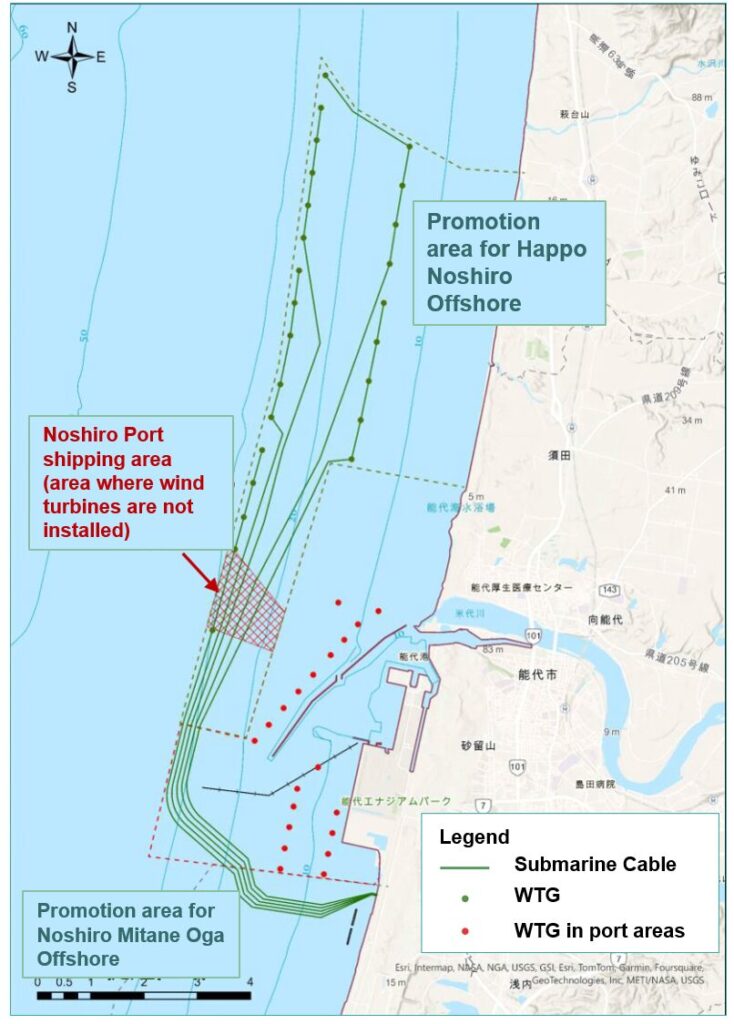

A site mostly under 30m deep, suited to fixed-bottom foundations. The developer plans to use Akita and Funakawa ports for foundations, Muroran Port for turbine installation, and Noshiro Port for operations and maintenance.
For a cost comparison with other zones on the same assumptions, see 👉 Cost Realities of Japan’s Offshore Wind: LCOE and IRR.
What to Watch Next
- The new start date for onshore works. A later start would push back COD, set at June 2029 at selection.
- What the government’s business-environment measures contain. The developer cites changed conditions, so measures such as price revisions will shape the schedule.
- The EIA final report, the stage after the draft report that must be completed before construction.
