Project ExecutionPublished January 31, 2025Updated October 31, 2026

Yurihonjo Offshore Wind: Re-tender Status After the Round 1 Exit

Offshore Yurihonjo City in Akita (north and south) is a designated Promotion Zone under Japan’s Renewable Sea Area Act, the law that sets out how sea areas are allocated for offshore wind. The developer selected in Round 1 withdrew in August 2025, so the zone is now waiting for a re-tender. The government opened information submissions for the re-tender on 26 November 2025, and the statutory council revised its consolidated opinion the same month. The timing and terms of the re-tender have not been published (as of October 2026).

This page tracks where the zone stands in the process and what gets decided next, using primary sources. It is updated monthly.

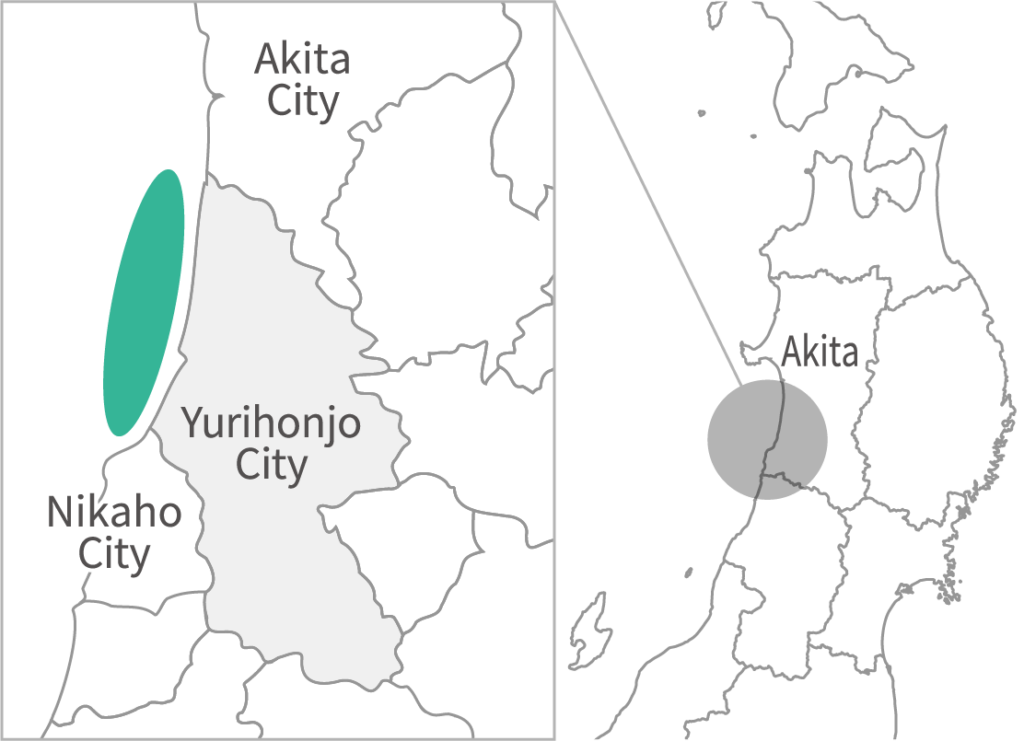

1. Where Yurihonjo Stands (October 2026)

StatusPromotion Zone (designated 21 July 2020; north and south areas)
FoundationFixed-bottom
Tender roundAwarded in Round 1; developer withdrew in August 2025. Re-tender timing not published
DeveloperNone (awaiting re-tender)
EIAOnly scoping documents from the withdrawn developer and Japan Wind Development remain. No new filing for the re-tender
Next stepsPublication of the re-tender guidelines, the document that sets the selection rules

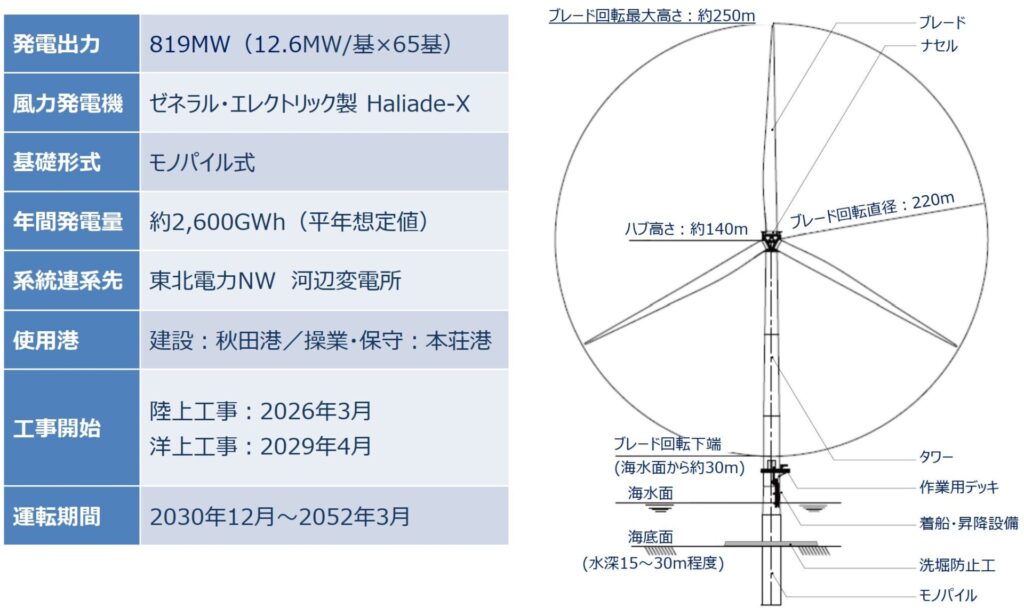

Round 1 recordAkita Yurihonjo Offshore Wind LLC (Mitsubishi Corporation Offshore Wind, CTECH, Venti Japan, Mitsubishi Corporation); JPY 11.99/kWh; 845MW (65 × 13MW); planned COD December 2030
Source: Agency for Natural Resources and Energy, MLIT, Ministry of the Environment and local government publications. Round 1 figures are a record at the time of withdrawal and do not indicate re-tender levels.

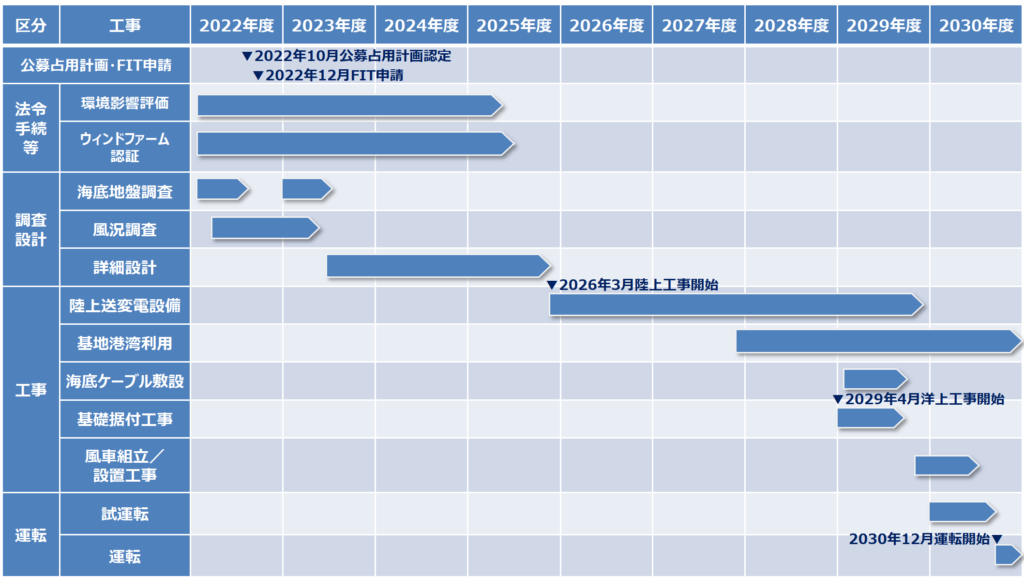

2. From Designation to Re-tender: Timeline

DateEventSource
Jul 2020Designated as a Promotion Zone (north and south)METI
Dec 2021Round 1 awards Akita Yurihonjo Offshore Wind LLC at JPY 11.99/kWhMETI
Aug 2025Selected developer announces withdrawalMETI
26 Nov 2025Government opens information submissions from developers ahead of the re-tenderMETI
Nov 20257th statutory council, the forum where national and local government, municipalities and fishers agree how the area is used revises its consolidated opinionMETI
Dec 2025METI and MLIT publish their analysis of the Round 1 withdrawalsMETI, MLIT

The withdrawal followed a low winning price in 2021 and the rise in material costs and interest rates that came after. See 👉 Why Japan’s Offshore Wind Round 1 Ended in Withdrawal.

3. EIA Status: No New Filing for the Re-tender

Japan’s environmental impact assessment runs in four stages: a primary document, a scoping document, a draft report with survey and prediction results, and a final report. Two scoping documents remain for Yurihonjo, from the withdrawn developer and from Japan Wind Development (2020). No new procedure has been filed for the re-tender.

ProjectDeveloperStageNotice
Yurihonjo offshore wind (provisional)Akita Yurihonjo Offshore Wind LLCScoping document (developer withdrew Aug 2025)2022/06
Yurihonjo offshore wind (provisional)Japan Wind DevelopmentScoping document2020/12
Source: Environmental Assessment Database (Ministry of the Environment), retrieved 31 October 2026. 2 further procedure(s) in this area have been withdrawn.

4. Site Conditions

A site roughly 15m to 30m deep, suited to fixed-bottom foundations. The Round 1 plan used Akita Port for construction and Honjo Port for operations and maintenance, with a connection to Tohoku Electric Power Network’s Kawabe substation.

For a cost comparison with other zones on the same assumptions, see 👉 Cost Realities of Japan’s Offshore Wind: LCOE and IRR.

What to Watch Next

  • When the re-tender guidelines are published. Information submissions opened on the same day as for Noshiro and Choshi, so the three zones are likely to move as a group.
  • The conditions in the revised council opinion. Fisheries coexistence and local benefit conditions feed into the re-tender requirements.
  • Whether a new EIA filing appears. Any developer preparing for the re-tender would start with a primary document.
