Project ExecutionPublished February 1, 2025Updated October 31, 2026

Choshi Offshore Wind: Re-tender Status and TEPCO RP’s EIA

Offshore Choshi City in Chiba Prefecture is a designated Promotion Zone under Japan’s Renewable Sea Area Act, the law that sets out how sea areas are allocated for offshore wind. The developer selected in Round 1 withdrew in August 2025, so the zone is now waiting for a re-tender. The government opened information submissions for the re-tender in November 2025, and in August 2026 TEPCO Renewable Power started a new environmental impact assessment for the area. The timing and terms of the re-tender have not been published (as of October 2026).

This page tracks where the zone stands in the process and what gets decided next, using primary sources. It is updated monthly.

1. Where Choshi Stands (October 2026)

StatusPromotion Zone (designated 21 July 2020)
FoundationFixed-bottom
Tender roundAwarded in Round 1; developer withdrew in August 2025. Re-tender timing not published
DeveloperNone (awaiting re-tender)
EIATEPCO Renewable Power filed a primary EIA document in August 2026. It has reportedly said no decision has been made on bidding
Next stepsChiba governor’s opinion on the EIA filing (due 13 November 2026); publication of the re-tender guidelines, the document that sets the selection rules

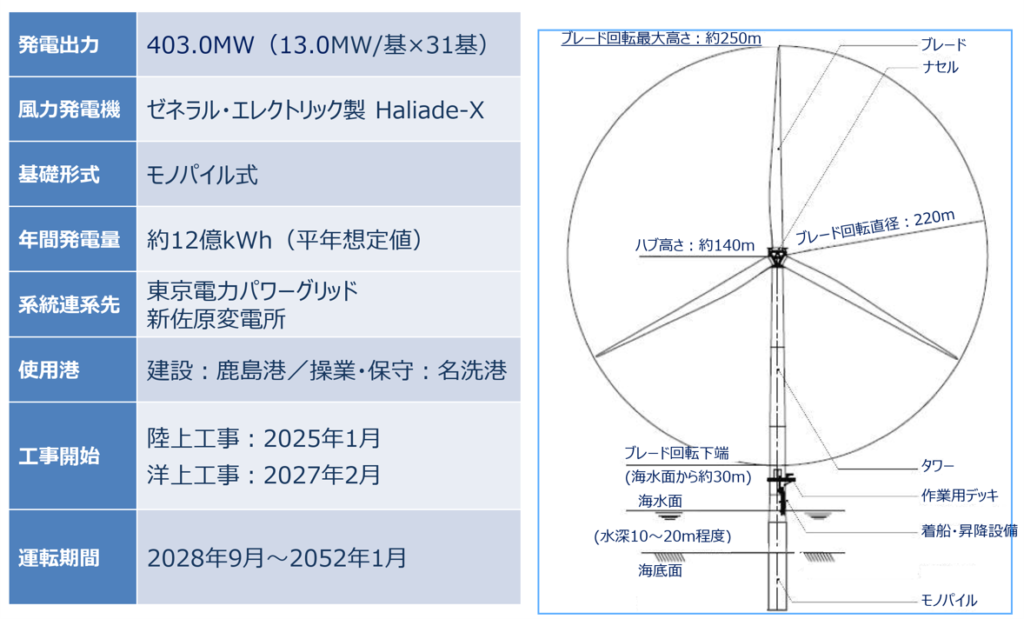

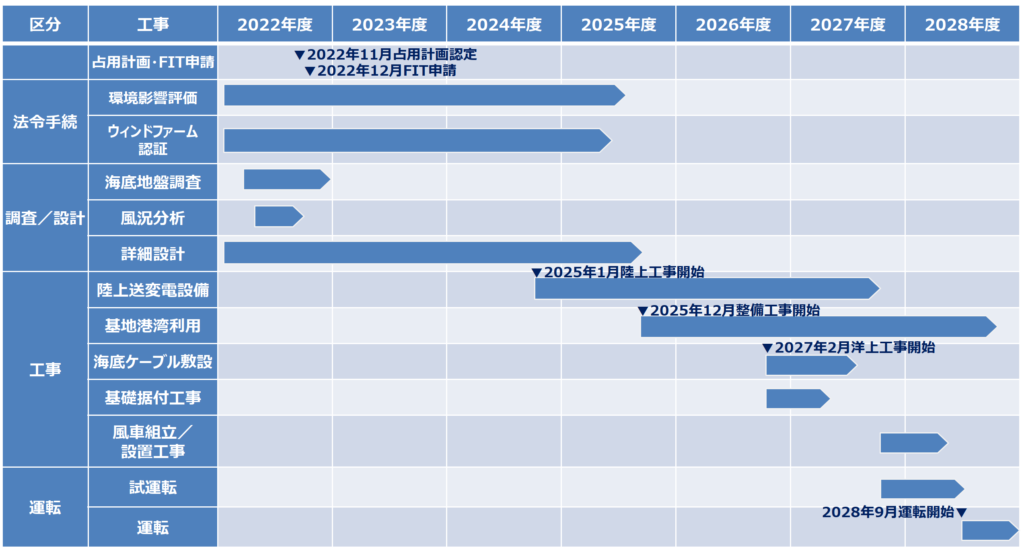

Round 1 recordChiba Choshi Offshore Wind LLC (Mitsubishi Corporation Offshore Wind, CTECH, Mitsubishi Corporation); JPY 16.49/kWh; 403MW (31 × 13MW); planned COD September 2028
Source: Agency for Natural Resources and Energy, Chiba Prefecture, Ministry of the Environment. Round 1 figures are a record at the time of withdrawal and do not indicate re-tender levels.

2. From Designation to Re-tender: Timeline 2020 to 2026

DateEventSource
Jul 2020Designated as a Promotion ZoneMETI
Dec 2021Round 1 awards Chiba Choshi Offshore Wind LLC at JPY 16.49/kWhMETI
Mar 2022TEPCO Holdings, not selected, closes its EIA procedureChiba Prefecture
Feb 2025Mitsubishi Corporation reassesses its three Japanese projects and books an impairment5th council papers
Aug 2025Selected developer announces withdrawalChiba Prefecture
26 Nov 2025Government opens information submissions from developers ahead of the re-tenderMETI
Dec 2025METI and MLIT publish their analysis of the Round 1 withdrawalsMETI, MLIT
5 Feb 20267th statutory council, the forum where national and local government, municipalities and fishers agree how the area is used. The government explains its new tender design, and a draft council opinion is presentedMETI
21 Aug 2026TEPCO Renewable Power gives public notice of its primary EIA document (open for review until 25 September)Chiba Prefecture
30 Oct 2026Minister of the Environment issues an opinion on that document (seabirds, marine life, landscape)MOE

The withdrawal followed a low winning price in 2021 and the rise in material costs and interest rates that came after. The government’s analysis and what it means for tender design are covered in 👉 Why Japan’s Offshore Wind Round 1 Ended in Withdrawal.

3. EIA Status: One Active Filing, from TEPCO RP

Japan’s environmental impact assessment runs in four stages: a primary document, a scoping document, a draft report and a final report. The primary document is the first-stage filing that sets out environmental considerations for a plan. The only active procedure for Choshi is TEPCO Renewable Power’s primary document.

ProjectDeveloperStageScaleUpdated
Choshi City Offshore Wind (provisional)TEPCO Renewable PowerPrimary documentUp to about 420MW (21 to 27 × 15 to 20MW)2026/08/25
Offshore Choshi, Chiba (provisional)Chiba Choshi Offshore Wind LLCEnded at draft report (withdrew Aug 2025)Up to 403MW (31 × 13MW)2025/02/04
Choshi Offshore Wind (provisional)TEPCO HoldingsWithdrawn (Mar 2022)–2024/05/21
Source: Environmental Assessment Database (Ministry of the Environment), Chiba Prefecture EIA committee papers

TEPCO RP’s filing covers about 40km² of sea for fixed-bottom turbines. Construction is reported to start in fiscal 2031 or later, with operation from fiscal 2032 or later. On 30 October 2026 the Minister of the Environment asked for proper surveys and mitigation for seabirds such as the common murre, for marine life, and for views from Tennodai Park and other viewpoints.

An EIA filing is separate from bidding in the re-tender. TEPCO RP has reportedly said nothing has been decided on bidding, so it should not be read as the next developer.

4. Site Conditions

Choshi is a shallow Pacific-coast site suited to fixed-bottom foundations, at water depths of around 20m. The Round 1 plan used Kashima Port in Ibaraki for construction and Naarai Port in Choshi for operations and maintenance, with a grid connection to TEPCO Power Grid’s Shin-Sawara substation.

For a cost comparison with the other Promotion Zones on the same assumptions, see 👉 Cost Realities of Japan’s Offshore Wind: LCOE and IRR.

5. What to Watch Next

  • When the re-tender guidelines are published. Information submissions opened on the same day for Choshi and the two Akita zones that also lost their Round 1 developer (Noshiro, Mitane and Oga; Yurihonjo), so the three are likely to move as a group.
  • How the council’s consolidated opinion is revised. Its conditions on fisheries coexistence and local benefits feed into the re-tender requirements.
  • The Chiba governor’s opinion (due 13 November) and whether TEPCO RP moves to a scoping document, the next stage that fixes what will be surveyed and how.
