450MW Yamagata Yuza Offshore Wind Project

Yamagata Yuza Offshore Wind

Japan is accelerating the deployment of offshore wind power, and one of the most symbolic projects in this effort is the Yamagata Yuza Offshore Wind Power Project. This initiative is part of the Japanese government’s third round of offshore wind power auctions—commonly known as “Round 3”—and represents a critical step toward achieving the national targets of 10 GW of offshore wind capacity by 2030 and 30–45 GW by 2040.

With a total planned capacity of 450 MW, the project will significantly contribute to the decarbonization of Japan’s energy mix through fixed-bottom offshore wind power. It is also expected to drive regional industrial development and economic revitalization. This article provides a detailed overview of the project, including installation locations, site conditions, and schedules.

➡ For an overview of all ten Promotion Areas as of 2025, see:
Promotion Areas for Offshore Wind in Japan – 2025 Overview

1. Project Overview

Project nameYamagata Yuza Offshore Wind
DeveloperYamagata Yusa Offshore Wind LLC
stakeholdersMarubeni
Kansai Electric Power
BP Iota Holdings Limited
TOKYO GAS
Marutaka CORPORATION
LocationOffshore Yuza town, Yamagata Prefecture
TypeFixed-bottom Offshore Wind Power
WTGSGRE
Price3 JPY/kWh
Capacity450 MW (15 MW × 30 turbines)
Start of ConstructionNovember 2027
Operation PeriodJune 2030 –2055
Source: Created from public document by the Agency for Natural Resources and Energy, METI

2. Location and Site conditions

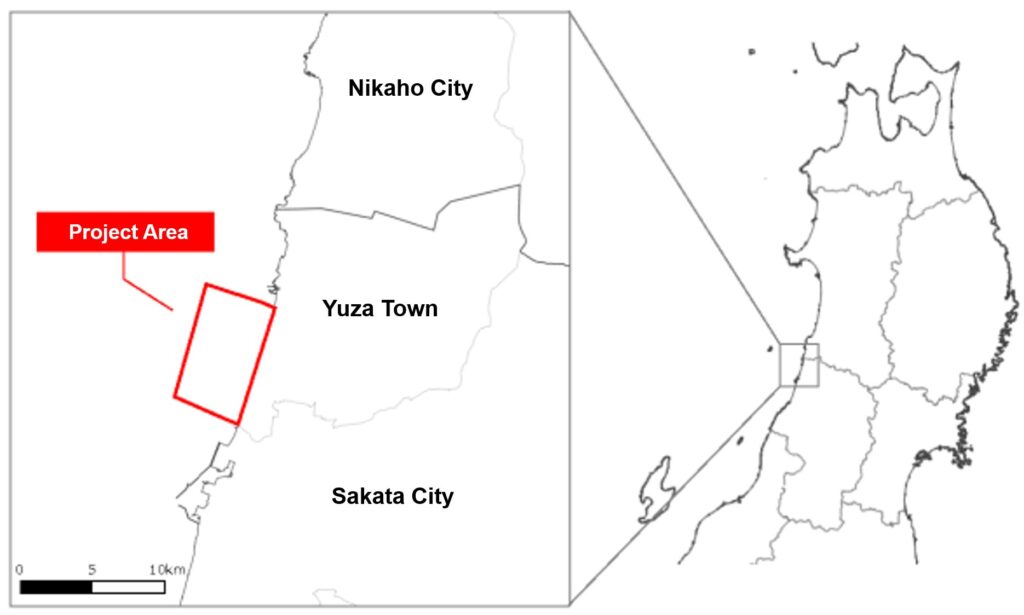

Location of Yamagata Yuza offshore wind
Source: Created from the Info of website of Marubeni

2-1. Wind Conditions

Yuza offshore wind wind conditions
Source: Overview map of the offshore area of Yuza Town, Yamagata Prefecture

The wind speed within the zone is approximately 7.0–8.0 m/s (at 100 m altitude).

2-2. Water Depth

Yuza offshore wind water depth
Source: Overview map of the offshore area of Yuza Town, Yamagata Prefecture

Within the zone, approximately 15% of the area has a water depth of less than 15 m, approximately 65% is less than 30 m, and approximately 80% is less than 35 m.
The deepest point within the zone reaches approximately 41 m.

2-3. Seabed Conditions

Yuza offshore wind seabed conditions
Source: Seabed ground investigation in the offshore area of Yuza Town, Yamagata Prefecture

No exposed bedrock has been confirmed within the zone.
Regarding the soil properties at cone penetration test investigation points, the layer down to approximately 6 m from the seabed surface consists of loose sandy soil. Below that, sandy soil layers continue as the dominant formation, transitioning to densely compacted sandy soil as the primary stratum from approximately 20 m depth.

2-4. Port Infrastructure

Yuza offshore wind port area
Source: Overview map of the offshore area of Yuza Town, Yamagata Prefecture

Sakata Port is planned to be utilized as the construction base port.

3. Project Overview

3-1. Consortium Members

Marubeni Corporation

A leading general trading company with the most extensive track record in offshore wind power in Japan.

Kansai Electric Power Co., Inc.

One of the largest electric power companies in Japan.

BP Iota Holdings Limited

A global top-tier international energy company.

Tokyo Gas Co., Ltd.

Japan’s largest gas utility and a leading new power supplier.

Marutaka Co., Ltd.

One of the largest general construction companies based in the Shonai region.

3-2. Project Implementation Structure

Construction Phase

This image has an empty alt attribute; its file name is Yamagawa-Yuza-Const-Organization.png

Source: Public document by the Agency for Natural Resources and Energy, METI

Operation Phase

This image has an empty alt attribute; its file name is yamagata-yuza-operation-organization.png

Source: Public document by the Agency for Natural Resources and Energy, METI

4. Project Schedule

4-1. Overall schedule

  • January 24, 2022: 1st Statutory Council Meeting
  • September 2, 2022: 2nd Statutory Council Meeting
  • December 19, 2022: 3rd Statutory Council Meeting
  • March 29, 2023: 4th Statutory Council Meeting
  • November 17, 2025: 5th Statutory Council Meeting
Yuza offshore wind schedule

Development & Design Phase (2024–2027)

  • December 2024: Award of Public Auction
  • Environmental Impact Assessment, Wind Conditions, Wave and Seabed Geological Surveys
  • Local Stakeholder Consultations and Coordination
  • Wind Farm Certification and Construction Plan Submission

Construction Phase (2027–2030)

  • November 2027: Construction of Onshore Substation and Transmission Infrastructure
  • March 2029: Installation of Offshore Foundations and Cables
  • July 2029: Turbine Assembly and Installation

Operation & Maintenance Phase (2030–2055)

  • Turbine Maintenance: SGRE
  • Operation Management (BOP): SPC

Decommissioning & Repowering Phase (Post-2055)

Source: Public document by the Agency for Natural Resources and Energy, METI

4-2. EIA status

事業名称
Project name
事業者名
Developer
手続段階
EIA Stage
容量
Capacity
基数
Turbines
出力
Rating
更新日
Last Updated
(仮称)山形県遊佐沖洋上風力発電事業
Yuza Offshore Wind Project
遊佐沖洋上風力発電に係る環境アセスメント共同実施コンソーシアム
Consortium for Joint Implementation of Environmental Assessment for Yuza Offshore Wind Power Project
方法書
Method Statement
Up to 450MWUp to 529.5 – 15MW2025/3/25
(仮称)山形県飽海郡遊佐町沖着床式洋上風力発電事業
Fixed-Bottom Offshore Wind Power Project off Yuza Town, Akumi District
伊藤忠商事株式会社
ITOCHU Corporation
配慮書
Scoping Document
Up to 494MWUp to 529.5 – 15MW2022/04/05
(仮称)遊佐洋上風力発電事業
Yuza Offshore Wind Power Project
日本風力開発株式会社
Japan Wind Development
方法書
Method Statement
Up to 500MW36 – 469.5 – 15MW2022/03/22
出典:環境アセスメント事例情報(環境省)
Source: Environmental Impact Assessment Case Information (Ministry of the Environment, Japan)

5. LCOE and IRR Estimation

Evaluating the bankability of offshore wind projects requires close attention to key cost indicators such as LCOE (Levelized Cost of Energy) and IRR (Internal Rate of Return). However, in Japan’s Promotion Zones, detailed project-level cost information remains limited in publicly available materials. As a result, investors and developers often lack sufficient data to form a fully informed assessment.

To address this gap, DeepWind applies a proprietary cost model using representative site conditions for each project, including wind resource (capacity factor), water depth, distance to port, and distance to grid connection point. Based on these input parameters, we estimate CAPEX, OPEX, LCOE, and IRR in a consistent framework.

This approach allows us to provide a cross-project comparison of the relative economic positioning of Japan’s Promotion Zone projects.

▶ For the latest model assumptions and updated relative positioning, please refer to the cost analysis Pillar article below.
👉 Cost Realities of Japan’s Offshore Wind: Analyzing LCOE and IRR Across 12 Promotion Zones (Latest Edition)

Conclusion

Yamagata Yuza Offshore Wind Power Project represents a significant milestone in Japan’s push for renewable energy. With a strong focus on sustainability, economic development, and technological innovation, it lays the foundation for the expansion of offshore wind power in Japan.

To explore how this area compares nationally and understand Japan’s offshore wind roadmap, visit:
Promotion Areas for Offshore Wind in Japan – 2025 Overview
your guide to Japan’s offshore wind Promotion Areas.
