420MW Nagasaki Saikai Enoshima Offshore Wind Project

Nagasaki Saikai Enoshima Offshore Wind

Japan is accelerating the deployment of offshore wind power, and one of the most symbolic projects in this effort is the Nagasaki Saikai Enoshima Offshore Wind Project. This initiative is part of the Japanese government’s 2nd round of offshore wind power auctions—commonly known as “Round 2”—and represents a critical step toward achieving the national targets of 10 GW of offshore wind capacity by 2030 and 30–45 GW by 2040.

With a total planned capacity of 420 MW, the project will significantly contribute to the decarbonization of Japan’s energy mix through fixed-bottom offshore wind power. It is also expected to drive regional industrial development and economic revitalization. This article provides a detailed overview of the project, including installation locations, site conditions, and schedules.

➡ For an overview of all ten Promotion Areas as of 2025, see:
Promotion Areas for Offshore Wind in Japan – 2025 Overview

1. Project Overview

The Nagasaki Saikai Enoshima Offshore Wind Project is a fixed-bottom offshore wind farm, strategically positioned to leverage strong wind resources in the East China Sea. Developed under Japan’s public auction system, this project aligns with the government’s goal of expanding offshore wind energy as a core component of the country’s energy mix.

Project nameNagasaki Saikai Enoshima Offshore Wind
Developermirai enoshima LLC
stakeholdersSumitomo Corporation
TEPCO
LocationOffshore saikai enoshima, nagasaki Prefecture
TypeFixed-bottom Offshore Wind Power
WTGvestas
Price22.18 JPY/ kWh
Capacity420 MW (15 MW × 28 turbines)
Start of Constructionnovember 2027
Operation Periodaugust 2029 – February 2055
Source: Created from public document by the Agency for Natural Resources and Energy, METI

2. Location and Site conditions

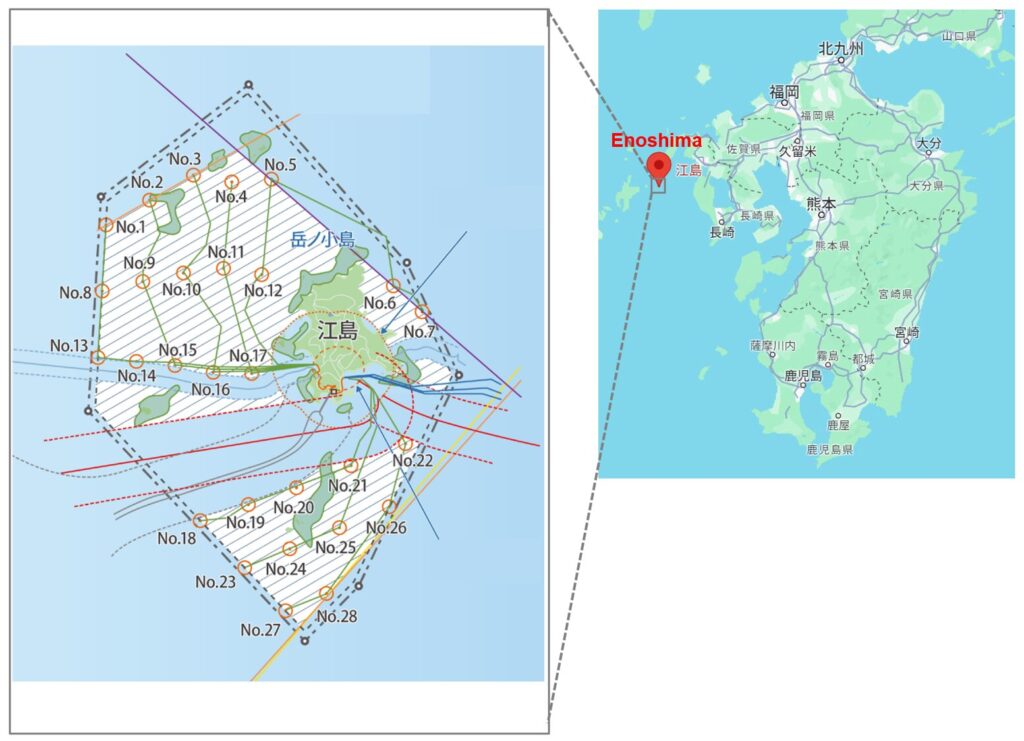

Location of Nagasaki Saikai Enoshima Wind
Source: Created from public document by the Agency for Natural Resources and Energy, METI

2-1. Wind Conditions

Saikai Enoshima offshore wind wind conditions
Source: Overview map of the offshore area of Enoshima, Saikai City, Nagasaki Prefecture

The wind speed within the zone is approximately 7.5–8.0 m/s (at 100 m altitude).

2-2. Water Depth

Saikai Enoshima offshore wind water depth
Source: Overview map of the offshore area of Enoshima, Saikai City, Nagasaki Prefecture

Within the zone, approximately 10% of the area has a water depth of less than 20 m, approximately 60% is less than 30 m, and approximately 95% is less than 40 m.
The deepest point within the zone reaches approximately 52 m.

2-3. Seabed Conditions

Saikai Enoshima offshore wind seabed conditions
Source: Survey on Natural Conditions of the Zone (Seabed Ground Investigation)

Areas of exposed bedrock have been confirmed within the zone, and the seabed topography has been found to be highly undulating.
Regarding the soil properties at cone penetration test investigation points, the layer from approximately 3–10 m from the seabed surface consists of sandy soil, below which bedrock (basement layer) is present.

2-4. Port Infrastructure

Saikai Enoshima offshore wind port area
Source: Overview map of the offshore area of Enoshima, Saikai City, Nagasaki Prefecture

There are only fishing ports in the vicinity of the zone, with no designated port area. The use of ports on the Kyushu mainland side is anticipated.

3. Project Overview

3-1. Consortium Members

Sumitomo Corporation

  • Proven track record in the development and operation of offshore wind projects in Europe, with a total of 1.9 GW currently in operation or under construction.

TEPCO Renewable Power

  • A subsidiary of Japan’s largest electric utility, with extensive experience across hydropower, wind, and solar, maintaining a total installed capacity of approximately 10 GW.

3-2. Project Implementation Structure

Construction Phase

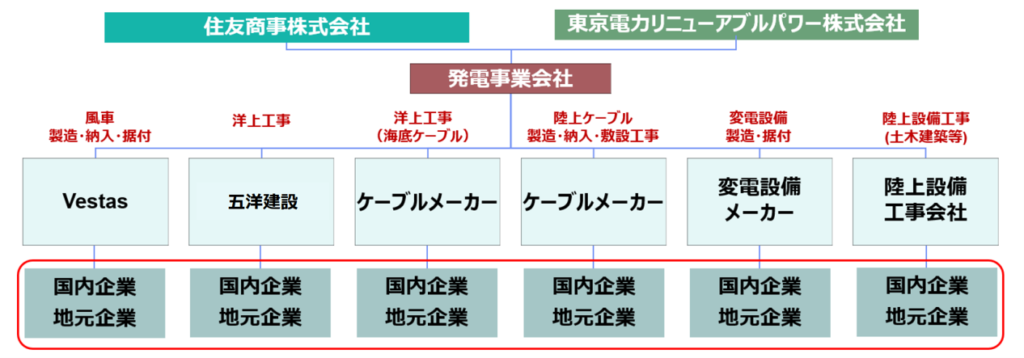

Nagasaki Saikai Enoshima Offshore Wind Construction organization
Source: Public document by the Agency for Natural Resources and Energy, METI

Operation Phase

Nagasaki Saikai Enoshima Offshore Wind Operation organization
Source: Public document by the Agency for Natural Resources and Energy, METI

4. Project Schedule

4-1. Overall schedule

  • April 23, 2021: 1st Statutory Council Meeting
  • September 30, 2021: 2nd Statutory Council Meeting
  • May 31, 2022: 3rd Statutory Council Meeting
  • November 22, 2024: 4th Statutory Council Meeting
  • February 13, 2026: 5th Statutory Council Meeting
Saikai Enoshima offshore wind schedule
Source: Project Overview Briefing for the Offshore Wind Project in the Offshore Area of Enoshima, Saikai City, Nagasaki Prefecture — 5th Statutory Council Meeting —
Saikai Enoshima offshore wind construction schedule
Source: Project Overview Briefing for the Offshore Wind Project in the Offshore Area of Enoshima, Saikai City, Nagasaki Prefecture — 5th Statutory Council Meeting —

Development & Design Phase (2024–2025)

  • March 2024: Award of public auction
  • Environmental impact assessment, wind, wave, and seabed geological surveys
  • Local stakeholder consultations and coordination
  • Wind farm certification and submission of construction plan

Construction Phase (2025–2029)

  • January 2025: Construction of onshore substation and transmission infrastructure
  • January 2028: Installation of offshore foundations and cables
  • January 2029: Assembly and installation of wind turbines

Operation & Maintenance Phase (2029–2054)

  • Turbine maintenance: Vestas
  • Operation management (BOP): TEPCO Renewable Power

Decommissioning & Repowering Phase (Post-2054)

  • Decommissioning plan at end of wind farm’s service life
  • Potential repowering depending on future energy policy

4-2. EIA status

事業名称
Project name
事業者名
Developer
手続段階
EIA Stage
容量
Capacity
基数
Turbines
出力
Rating
更新日
Last Updated
長崎県西海市江島沖洋上風力発電事業
Nagasaki Saikai Enoshima Offshore Wind
みらいえのしま合同会社
Miraie Enoshima G.K.
準備書
Draft EIA Statement
420MW2815MW2026/1/13
出典:環境アセスメント事例情報(環境省)
Source: Environmental Impact Assessment Case Information (Ministry of the Environment, Japan)

5. LCOE and IRR Estimation

Evaluating the bankability of offshore wind projects requires close attention to key cost indicators such as LCOE (Levelized Cost of Energy) and IRR (Internal Rate of Return). However, in Japan’s Promotion Zones, detailed project-level cost information remains limited in publicly available materials. As a result, investors and developers often lack sufficient data to form a fully informed assessment.

To address this gap, DeepWind applies a proprietary cost model using representative site conditions for each project, including wind resource (capacity factor), water depth, distance to port, and distance to grid connection point. Based on these input parameters, we estimate CAPEX, OPEX, LCOE, and IRR in a consistent framework.

This approach allows us to provide a cross-project comparison of the relative economic positioning of Japan’s Promotion Zone projects.

▶ For the latest model assumptions and updated relative positioning, please refer to the cost analysis Pillar article below.
👉 Cost Realities of Japan’s Offshore Wind: Analyzing LCOE and IRR Across 12 Promotion Zones (Latest Edition)

Summary

The Nagasaki Saikai Enoshima Offshore Wind Project is a landmark development from Japan’s Round 2 offshore wind auctions. With a planned capacity of 420 MW, it will contribute significantly to the country’s offshore wind targets of 10 GW by 2030 and 30–45 GW by 2040, while also supporting regional industrial revitalization. Going forward, the project’s implementation will depend heavily on transmission system integration and onshore grid connection arrangements, which remain key elements in Japan’s offshore wind expansion.

To explore how this area compares nationally and understand Japan’s offshore wind roadmap, visit:
Promotion Areas for Offshore Wind in Japan – 2025 Overview
your guide to Japan’s offshore wind Promotion Areas.
